Production volume variance
Production volume variance
The formula for calculating fixed overhead volume variance is:
Where:
- is the standard FOH rate × the standard quantity of the cost driver allowed for actual output (i.e., SFR × AU, or SFR × SH)
- is the amount in the master budget
The following formula may also be helpful in case the CMA problem provided different inputs:
Where, if the cost driver is units produced:
- is the standard FOH rate. This could be calculated using the master budget.
- are the budgeted units expected to be produced in the master budget.
- are the actual units produced.
Mathematically, since the is constant in the formula, we are computing the effects of the differences between versus the .
Where, if the cost driver is not units produced:
- are the budgeted hours in the master budget
- are the standard hours allowed for the actual units produced.

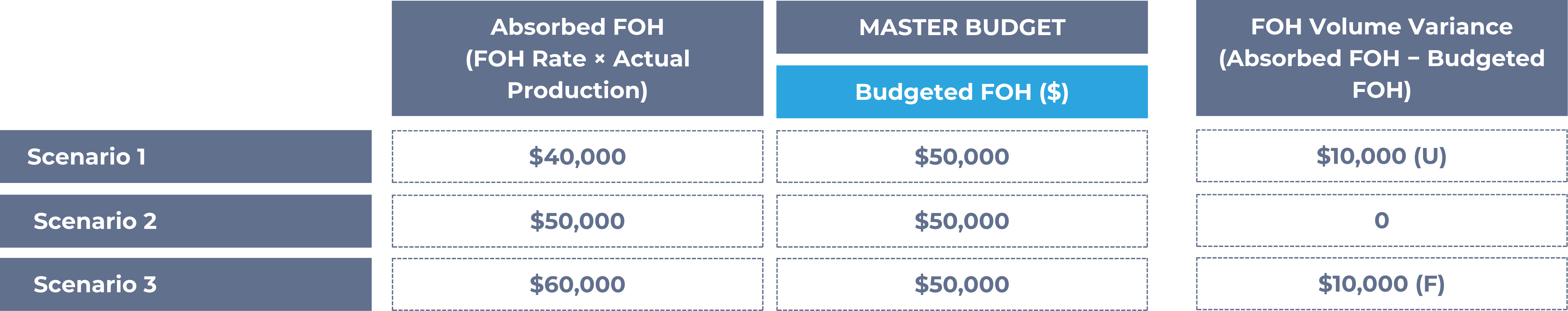

The table below shows the FOH volume variance for several different production scenarios:

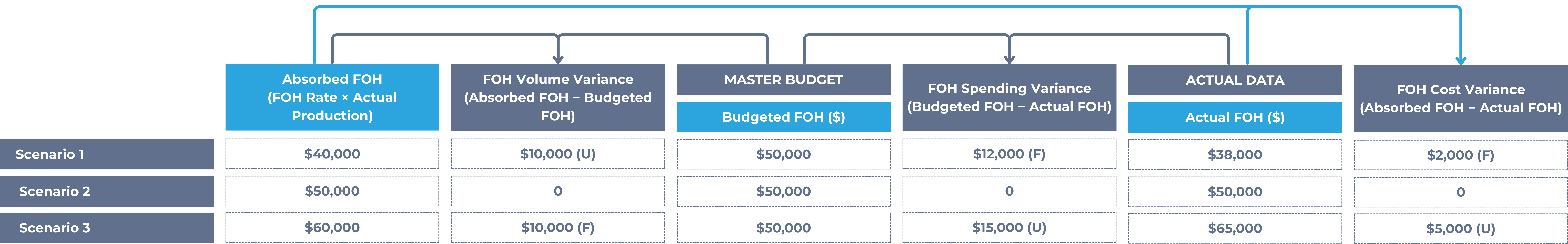

The table below verifies the FOH cost variance by summing the spending and volume variances for the same scenarios:
When the cost drivers for the FOH are not the units of production (e.g., machine hours), the fixed overhead (FOH) volume variance can be further analyzed through its two subcategories:
- Capacity variance
- Efficiency variance
Together, these subcategories provide deeper insights into whether variances arise from the under- or over-utilization of available production capacity or inefficiencies in the actual output relative to standard expectations.
FOH capacity variance
The FOH capacity variance is a component of the volume variance and it calculates the difference of the actual hours incurred by production versus the budgeted hours from the master budget, applying the standard FOH rate. Mathematically:
Where:
- is the standard FOH rate. This could be calculated using the master budget.
- are the budgeted (denominator-level) hours in the master budget.
- are the actual hours incurred by production.
The portion of the formula refers to the in the master budget.
Since the is constant in the formula, we are computing the effects of the differences between versus the .
When actual hours exceed budgeted hours, the variance is favorable because it indicates better utilization of production capacity. This means fixed overhead costs, which remain constant regardless of activity, are spread over more hours, effectively reducing the cost per unit of output and improving resource efficiency. Conversely, fewer actual hours result in an unfavorable variance, as capacity is underutilized, leading to higher fixed costs per unit.
FOH efficiency variance
The FOH efficiency variance is a component of the volume variance and it calculates the difference between the standard hours allowed for the actual units produced versus the actual hours incurred by production:
Where:
- is the standard FOH rate. This could be calculated using the master budget.
- are the standard hours allowed for the actual units produced.
- are the actual hours incurred by production.
The portion of the formula refers to the .
Since the is constant in the formula, we are computing the effects of the differences between versus the .
When standard hours exceed actual hours, the variance is favorable, as it indicates efficient use of labor or resources (i.e., less time was required to produce the expected output). Conversely, when actual hours exceed standard hours, the variance is unfavorable, as it suggests inefficiencies in production, requiring more time than expected to achieve the same level of output. This variance highlights how effectively production resources are utilized relative to expectations.
Example: FOH volume, capacity, and efficiency variances
Budgeted FOH is $100,000 based on 10,000 budgeted hours (BH), so the standard FOH rate (SFR) is $100,000 ÷ 10,000 = $10 per hour. For the period, actual production earned 9,000 standard hours (SH), and the actual hours incurred (AH) were 9,500.
- FOH volume variance: (unfavorable)
- FOH capacity variance: (unfavorable)
- FOH efficiency variance: (unfavorable)
Check: the capacity and efficiency variances add up to the volume variance: .
Answer: The $10,000 unfavorable volume variance splits into a $5,000 unfavorable capacity variance (fewer actual hours than budgeted) and a $5,000 unfavorable efficiency variance (more actual hours used than standard allowed).
